A worked example · my own house

Four ways to add space on a 0.12‑acre lot

We had a baby on the way and family who needed somewhere to live, and a 1,049 square foot house on a small lot to fit both into. I worked up four options far enough to price properly. This is all of them, with the drawings and the numbers.

Lot
5,227 sq ft
Existing house
1,049 sq ft
Options priced
Four
Built
C and D
01

What the lot allowed

The house was built in 2007 on an 18 ft by 34 ft footprint, two stories, three bedrooms. The lot is small and legally non‑conforming, so the binding constraints were setbacks and height. I worked those out before drawing anything.

The requirements aren’t the same for every option. An addition to the house is a principal structure. A detached ADU is an accessory structure and falls under a different set of rules. Same lot, different envelope, depending on what you build.

Zone GAddition to the houseDetached ADU
Side setback6 ft6 ft
Rear setback15 ft6 ft
Height30 ft, up to 40 ft28 ft
Height conditionSide setback at least 50% of heightAlso capped by a share of the house height
Lot coverage33% max33% max

The rear setback is what mattered. Fifteen feet for an addition against six for an ADU meant the two options had materially different buildable areas on the same piece of ground.

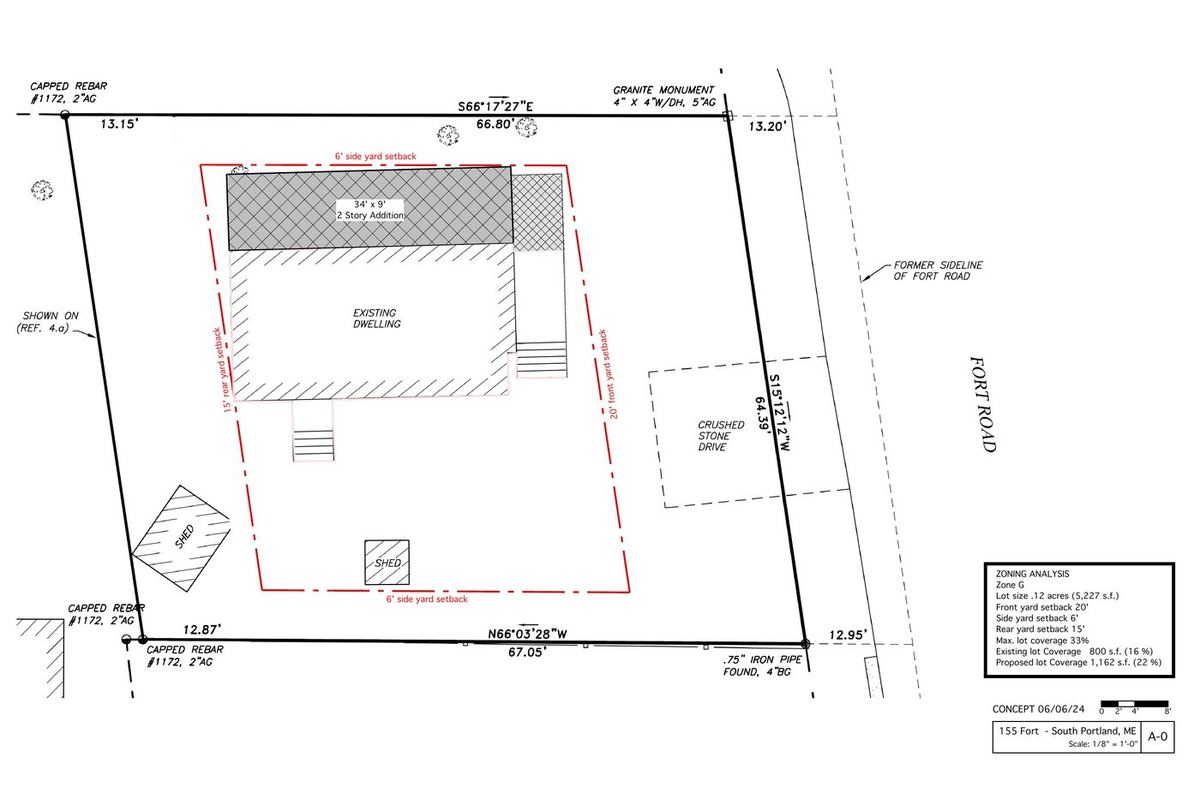

Site plan with the buildable envelope marked in red dashed line against the property boundary
The buildable envelope drawn out. The red dashed line is the limit the setbacks create, and everything has to sit inside it. This is the drawing that tells you what’s actually available before anyone designs anything.

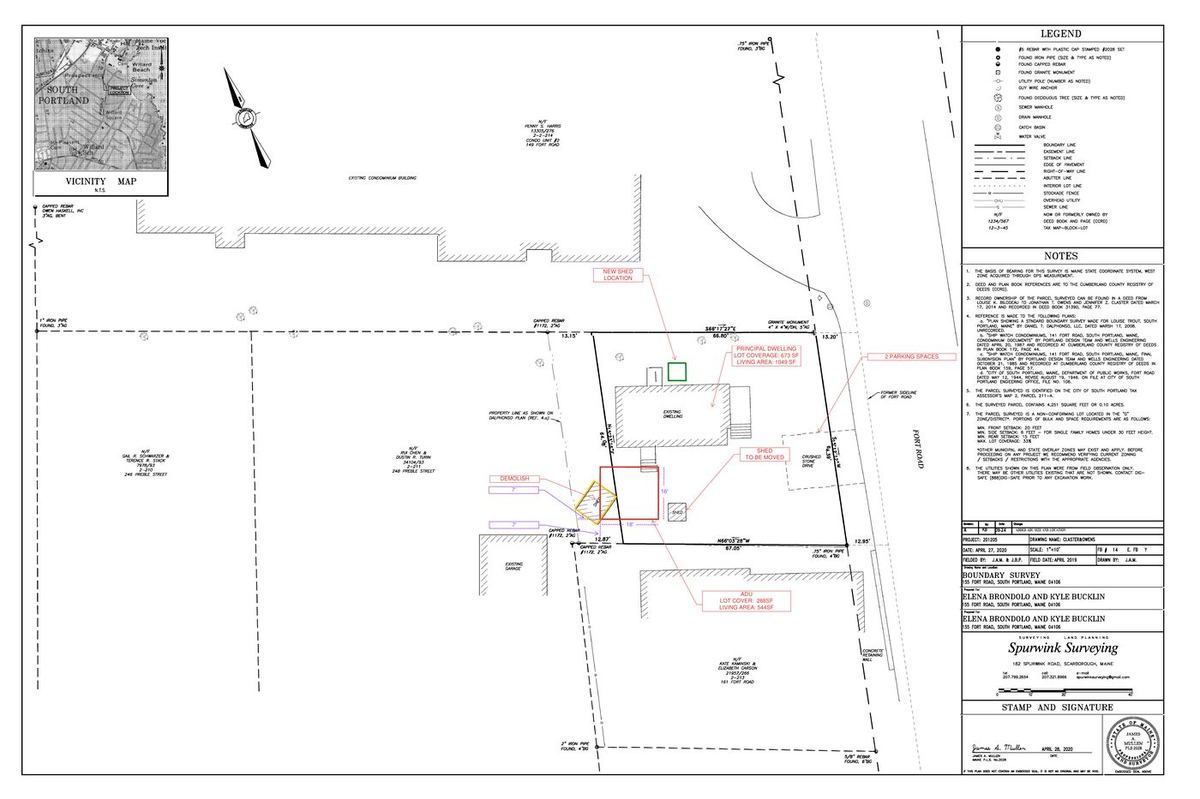

Boundary survey showing lot lines, easements and the existing dwelling
Boundary survey. Lot lines, easements and the existing footprint the envelope gets measured from.

Two numbers then shaped everything. We were using 16% of an allowed 33% lot coverage, and about 18 ft of an allowed 30 ft height. There was room on the ground and room in the air, and the four options split along that line.

Option A

Two-story rear addition

Not built

The first thing we looked at, and the one an architect drew. A 34 ft by 9 ft two-story addition across the back, with the first floor reworked around it — dining, office, powder room, mudroom and an extended porch, and a primary suite above. It was a good design. When a builder priced it, the number came back well past what we had in mind.

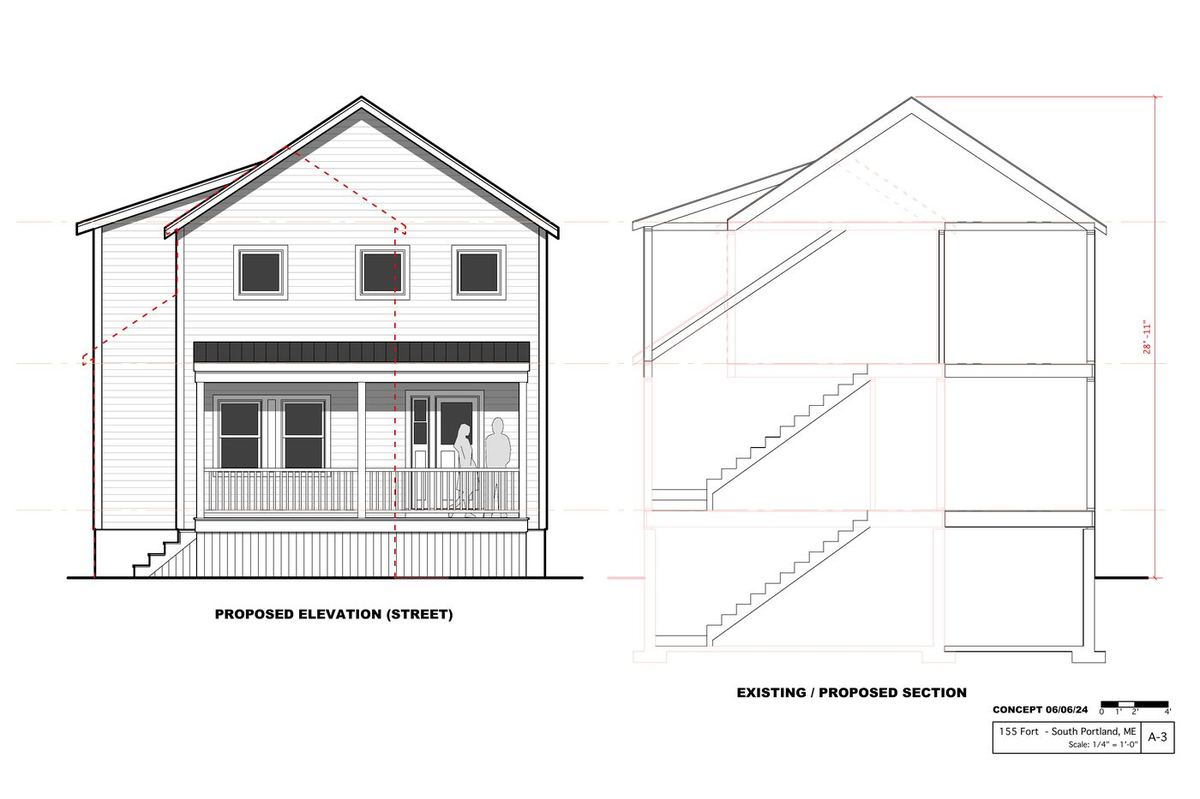

Proposed street elevation and building section
Street elevation and section. The addition runs the full 34 ft width across the back.

Cost breakdown

LineCostNotes
Site work and excavation$16,000Access is tight; spoil hauled off site
Foundation$58,000New frost wall and footings, plus underpinning and tie-in where the new wall meets the 2007 foundation
Framing and structural$68,000Two floors, roof tie-in, LVL beams over the removed rear wall
Roofing$11,000New roof over the addition, flashed into the existing
Windows and exterior doors$19,000
Siding and exterior trim$22,000Matched to existing
Insulation and air sealing$10,000
Plumbing$32,000New primary bath, powder room, kitchen relocated
Electrical$22,000Rough and finish, panel capacity added
HVAC$18,000New zones for the addition and the reworked first floor
Drywall and paint$24,000
Interior trim and doors$13,000
Flooring$15,000
Kitchen cabinets and counters$36,000First floor reworked around the addition
Bathrooms: fixtures and tile$20,000Primary bath and powder room
Porch and exterior stairs$10,000
Permits and city fees$4,000
Design and engineering$14,000Architect concept set plus structural
Contingency$18,000Roughly 4%; higher than usual because of the foundation tie-in
Total$430,000612 sq ft added · $703 per sq ft

Build sequence

01
Design and permitting

Architect concept set, structural design, building permit

6–8 wk
02
Excavation and foundation

Dig, footings, frost wall, underpin and tie into the 2007 foundation

3 wk
03
Framing and roof tie-in

Two floors, LVL over the removed rear wall, roof flashed into existing

4 wk
04
Exterior close-in

Roofing, windows, doors, siding

3 wk
05
Rough mechanicals

Plumbing, electrical, HVAC rough with inspections

3 wk
06
Insulation and drywall
3 wk
07
Interior finish

Kitchen, baths, trim, flooring, paint

6 wk
08
Punch and final inspections
2 wk
Option B

Detached accessory dwelling unit

Approved, not built

A two-story, one-bedroom ADU at the rear of the lot, 288 sq ft on the ground and 544 sq ft of living area, six feet off both the side and rear lines. I took this one all the way through zoning approval.

What I hadn't appreciated at the start is that an ADU is a dwelling, so it gets built to the same standard as a house. Frost-protected foundation, full envelope, heat, plumbing, electrical service, egress. You can't convert a shed into one. That's most of why the cost per square foot is so high on something this small.

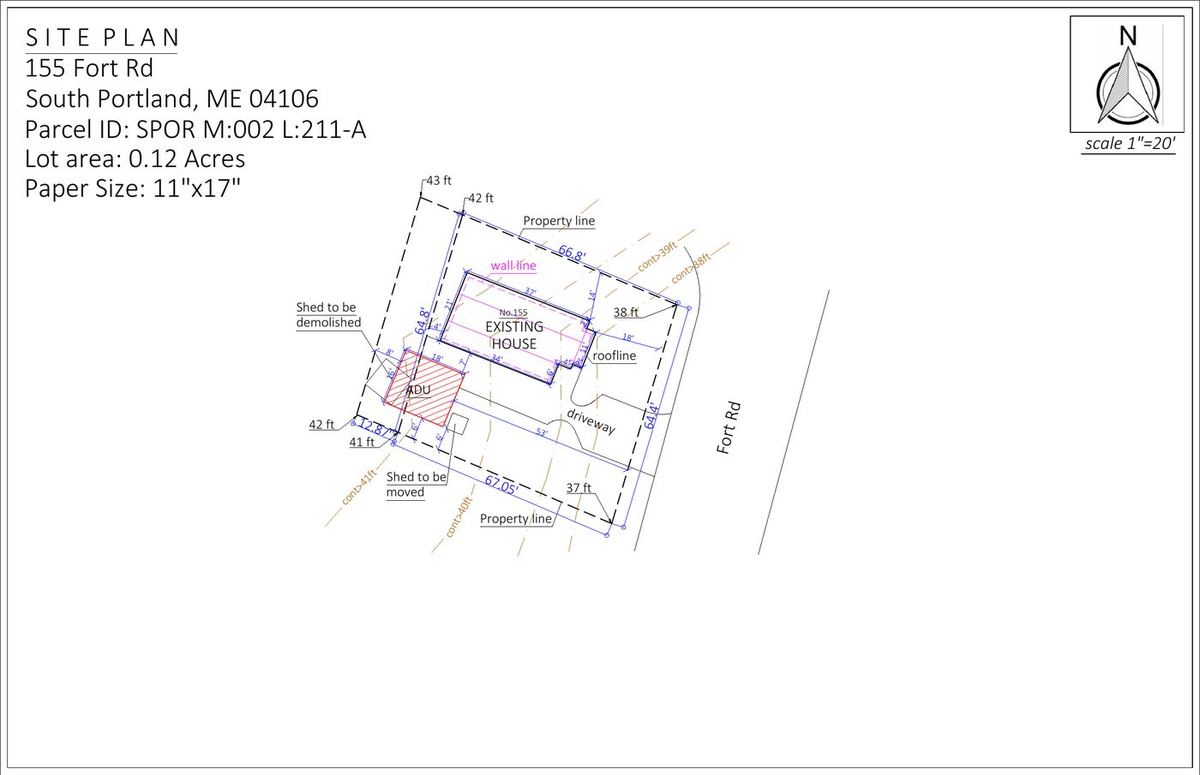

Site plan showing the ADU footprint at the rear of the lot
Site plan submitted with the zoning application. ADU footprint, sheds to be moved and demolished, grade contours.

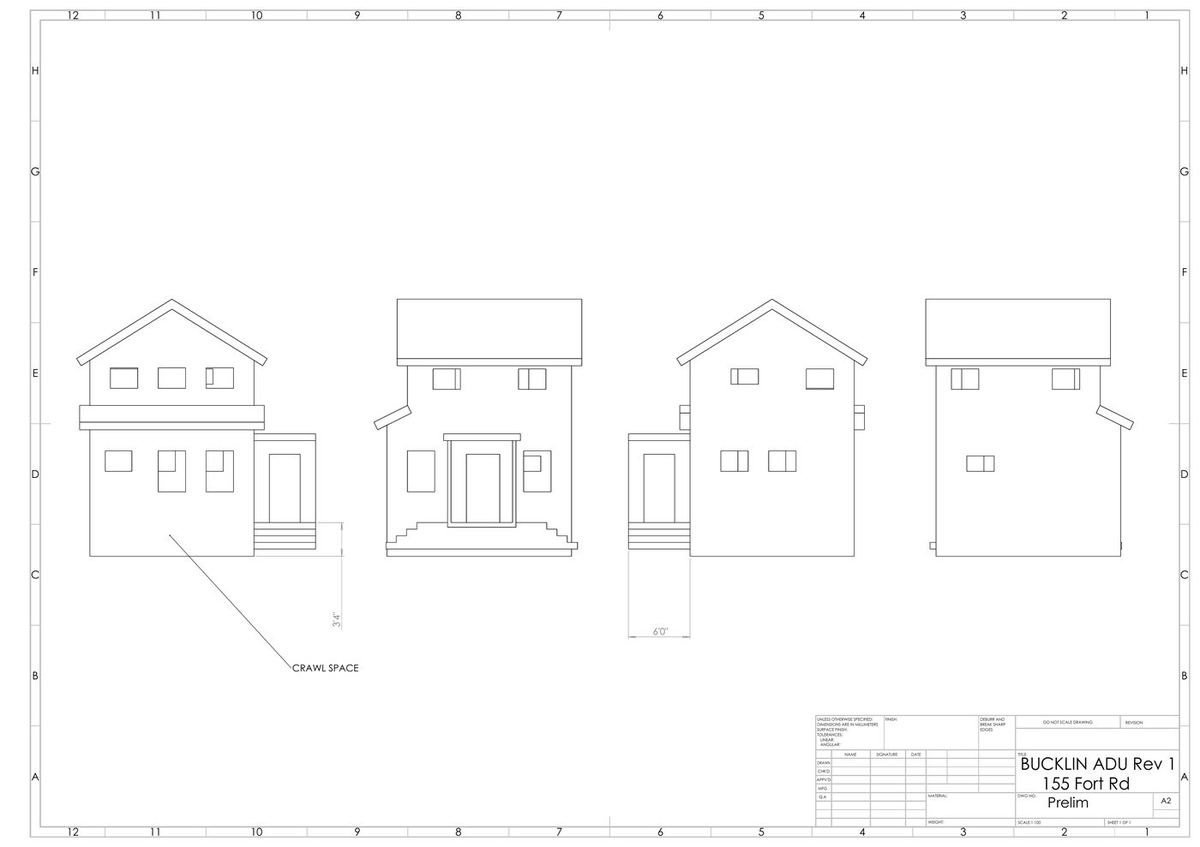

Elevations of the proposed accessory dwelling unit
ADU elevations, all four sides.

Cost breakdown

LineCostNotes
Site work, shed demolition and relocation$14,000One shed demolished, one moved to clear the footprint
Utility trenching from the house$18,000Water, sewer and electric run to a separate structure
Frost-protected foundation and slab$34,000Full dwelling standard; a shed slab does not qualify
Framing and structural$46,000Two stories on a 288 sq ft footprint
Roofing$8,000
Windows and exterior doors$14,000
Siding and exterior trim$16,000Required to complement the principal dwelling
Insulation and air sealing$11,000Full code envelope
Plumbing$26,000Kitchen, full bath, water heater, separate service
Electrical$19,000New subpanel and full unit wiring
HVAC$12,000Heat pump, independent of the house
Drywall and paint$15,000
Interior trim, doors and stairs$12,000
Flooring$9,000
Kitchenette$14,000
Bathroom: fixtures and tile$12,000
Survey revision and drainage plan$5,500Revised boundary survey, drainage narrative, $200 escrow
Permits, application and sewer impact fees$6,500$200 pre-app, $300 app, sewer impact by design flow
Design$9,000
Contingency$14,000
Total$315,000544 sq ft added · $579 per sq ft

Build sequence

01
Zoning application and approval

Revised survey, drainage plan, ADU application, STVR certificate

8–10 wk
02
Building permit and drainage review
4 wk
03
Site work

Shed demolition, shed relocation, utility trenching from the house

2 wk
04
Foundation and slab

Frost-protected, full dwelling standard

2 wk
05
Framing and roof

Two stories on a 288 sq ft footprint

3 wk
06
Exterior close-in

Windows, doors, siding, trim

3 wk
07
Rough mechanicals

Separate service, subpanel, water, sewer

2 wk
08
Insulation, drywall and finish
5 wk
09
Kitchen and bath
2 wk
10
Final inspections and certificate of occupancy

STVR restriction recorded at the registry before CO issues

2 wk
Option C

Third story on the existing footprint

Built

What we actually built. Take the roof off, extend the second floor five feet over the existing footprint, and put a full 18 ft by 34 ft third story on top with a flat roof. Finished at 26 ft 6 in against a 30 ft limit.

Nobody suggested this at the start. It only came up once I'd measured the height we weren't using against the lot coverage we weren't using.

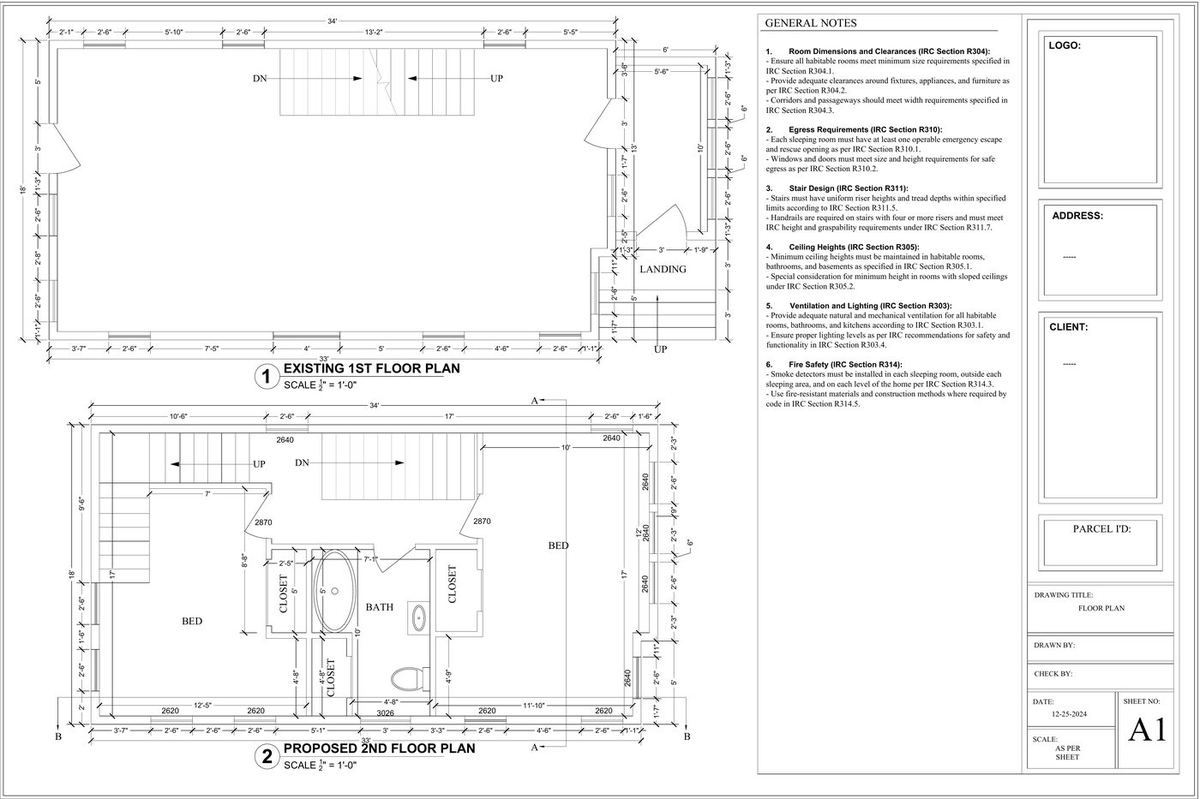

Permit set floor plans showing existing and proposed conditions
Permit set floor plans, existing and proposed.

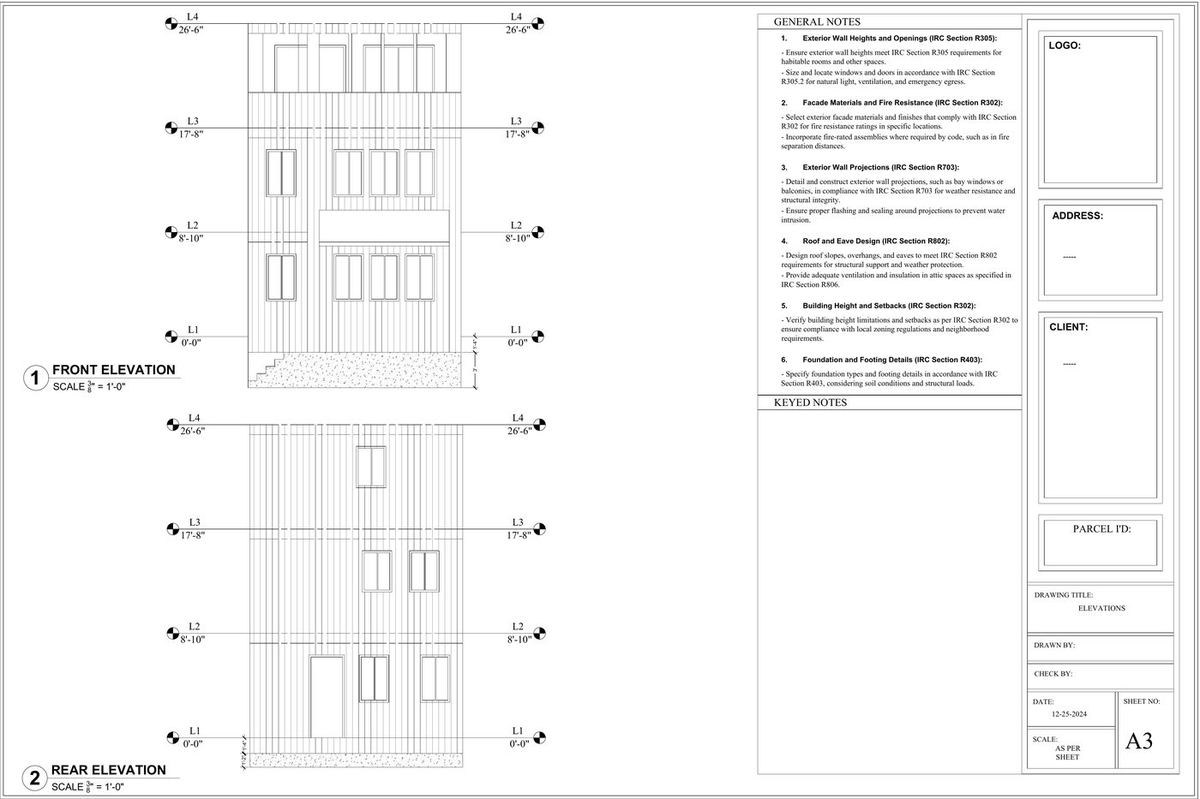

Front and rear elevations showing the added third story
Front and rear elevations with the third story added.

Cost breakdown

LineCostNotes
Site staging and protection$7,000House stays occupied through most of the work
Roof demolition and disposal$10,000Weather-critical; dry-in has to follow immediately
Structural reinforcement$20,000LVL beams and posts carried down to the existing foundation
Framing$54,000Second floor extended 5 ft, full 18 x 34 third floor
Flat roof system$18,000Membrane, tapered insulation, drainage
Windows and exterior doors$17,000
Siding and exterior trim$20,000Matched to existing on three elevations
Insulation and air sealing$12,000
Plumbing$18,000New bath, waste stack and supply extended up
Electrical$16,000Rough and finish, panel capacity added
HVAC$13,000System extended to the new floor
Drywall and paint$19,000
Interior trim, doors and stairs$14,000New stair run to the third floor
Flooring$11,000
Bathroom: fixtures and tile$11,000
Front porch finish and landing$8,000
Permits and sewer impact fee$3,500Sewer impact $945 on the increased bedroom count
Design and permit drawings$7,000
Contingency$21,500Roughly 7%; unknowns sit in the existing structure
Total$300,000782 sq ft added · $384 per sq ft

Build sequence

01
Design and permitting

Permit drawing set, structural review, building permit

6 wk
02
Structural reinforcement

LVL beams and posts carried down through the house to the existing foundation

2 wk
03
Roof demolition

Weather-critical. Dry-in has to follow immediately

1 wk
04
Framing

Second floor extended 5 ft, full 18 × 34 third floor

4 wk
05
Flat roof and dry-in

Membrane, tapered insulation, drainage

2 wk
06
Exterior close-in

Windows, doors, siding matched to existing

3 wk
07
Rough mechanicals

Waste stack and supply extended up, HVAC to the new floor

3 wk
08
Insulation and drywall
3 wk
09
Interior finish

New stair run, bath, trim, flooring, paint

5 wk
10
Final inspections
1 wk
Option D

Finished basement

Complete

A 305 sq ft bedroom and a 90 sq ft bathroom inside the foundation that was already there. We ran this alongside the third story rather than instead of it, and it's finished now.

The complication is drainage. The shower and toilet sit below the sewer line, so the floor had to be opened and a pump-up basin set before anything else could happen.

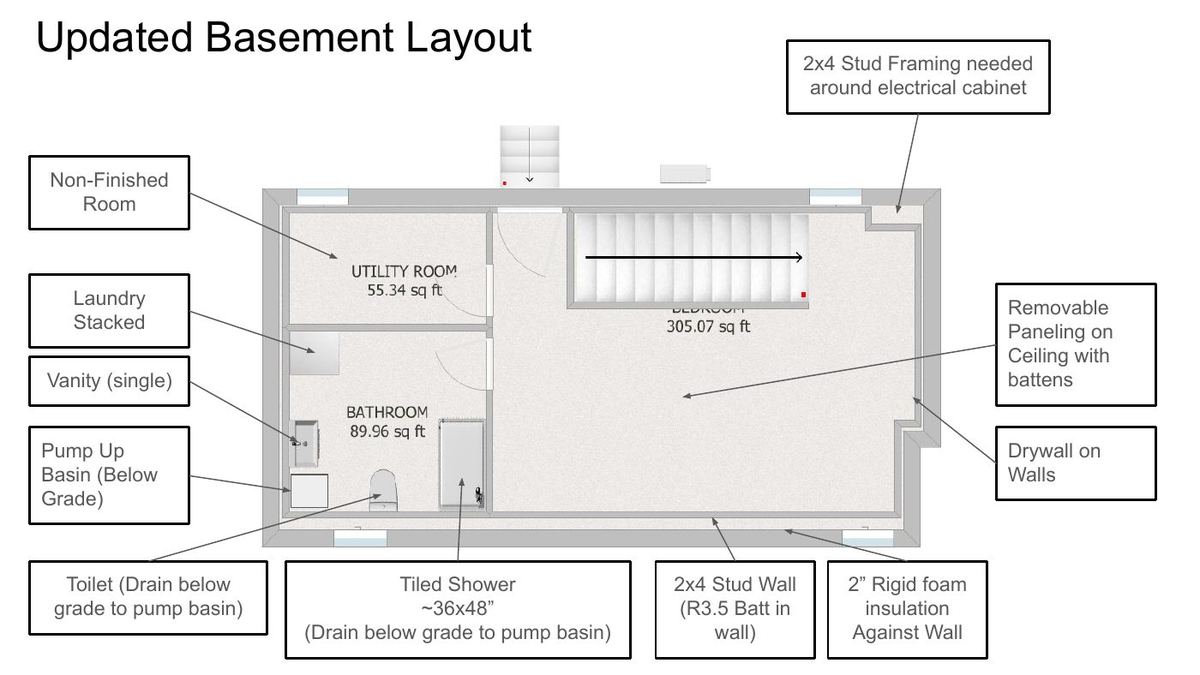

Annotated basement layout with construction notes
Basement layout with the build notes on it — framing, insulation, drainage and fixture locations.

Cost breakdown

LineCostNotes
Concrete cutting and sub-grade drainage$7,500Floor opened for shower and toilet drains
Pump-up basin and ejector$4,800Fixtures sit below the sewer line
Rigid foam and vapor control$5,2002 in. against the foundation wall
Framing$8,6002x4 walls, soffits, chase around the electrical cabinet
Batt insulation$2,400R3.5 in the stud cavity
Plumbing rough and finish$11,500
Electrical rough and finish$7,800
HVAC$4,200Supply, return and dehumidification
Drywall and paint$8,400
Interior doors and trim$3,600
Flooring$4,100
Tiled shower and bath fixtures$9,20036 x 48 shower, single vanity
Laundry hookups$1,900Stacked unit
Removable ceiling panels and battens$2,800Keeps access to joist-bay mechanicals
Permits$600
Contingency$5,400
Total$88,000395 sq ft added · $223 per sq ft

Build sequence

01
Permit and electrical rough-in

Rough-in inspected before anything was closed

2 wk
02
Concrete cutting and drainage

Floor opened for shower and toilet drains to the basin

1 wk
03
Pump basin and plumbing rough

Ejector set, supply and waste run

2 wk
04
Rigid foam and framing

2 in. foam against the wall, 2×4 walls, chase around the electrical cabinet

2 wk
05
Mechanical rough and inspections

HVAC supply and return, dehumidification

2 wk
06
Insulation and drywall

R3.5 batt in the stud cavity

2 wk
07
Tile, fixtures and trim

36 × 48 tiled shower, vanity, doors

3 wk
08
Flooring and paint
2 wk
09
Final inspection
1 wk
06

The four side by side

OptionAddedCostPer sq ftFoundationRear yard
A — Rear addition612 sq ft$430,000$703NewConsumed
B — Detached ADU544 sq ft$315,000$579NewConsumed
C — Third story782 sq ft$300,000$384NoneRetained
D — Basement395 sq ft$88,000$223NoneRetained
C and D together1,177 sq ft$388,000$330NoneRetained

The cost per square foot falls in a straight line as you use more of what’s already there. A builds everything new on new ground. B does the same and has to meet full dwelling standards on a tiny footprint. C uses the existing foundation and structure. D uses the existing foundation, walls and roof.

The single biggest difference is the foundation. Option A carried $74,000 in excavation and foundation work, and a chunk of that was underpinning and tying a new frost wall into the 2007 foundation. Option C carried $17,000 in staging and roof demolition and no foundation work at all, because nothing new touched the ground. That one line accounts for most of the gap between the two, and it’s why the option nobody suggested turned out to be the cheapest way to get the most space.

There’s a second thing the table doesn’t show. A and B both used the same rear yard, so they were alternatives to each other. C and D used structure that already existed, so they could run in sequence. We built C, finished D, and the rear yard is still there if we want to build the ADU later.

07

How I put the numbers together

Every option here is broken into the same lines so they can be compared honestly. A quote for one design and a rough guess at another isn’t a comparison, it’s a preference.

Where the numbers come from

Option A is a builder’s quote against the architect’s concept set, broken back out into lines. Option C is what we actually spent. Options B and D are modelled from current Greater Portland pricing at the same level of detail.

Estimates at this stage are for comparing options and setting a budget, not for signing a contract. Real pricing comes from a builder against a real scope, and getting you to that point is part of the work.

Your lot isn’t this lot.

Different zoning, different setbacks, different house. The sequence is the same though. Find out what the rules allow, develop the real options far enough to price them, and compare them before you commit to any one.

Tell me about your project
South Portland, Maine. Drawings from the June 2024 concept set, the November 2024 ADU zoning application, the December 2024 building permit set, and the basement layout revised November 2025. Zoning standards were current at the time of filing and should be re-confirmed against present City records before relying on them.
